2025
January 2025
Approvals From LDA, WASA, EPA TEPA & Revenue Departments.
Mayfair LDA Approved
February 2025
Land Demarcations, Soil & Allied Testings along with installation of batching plants on site.

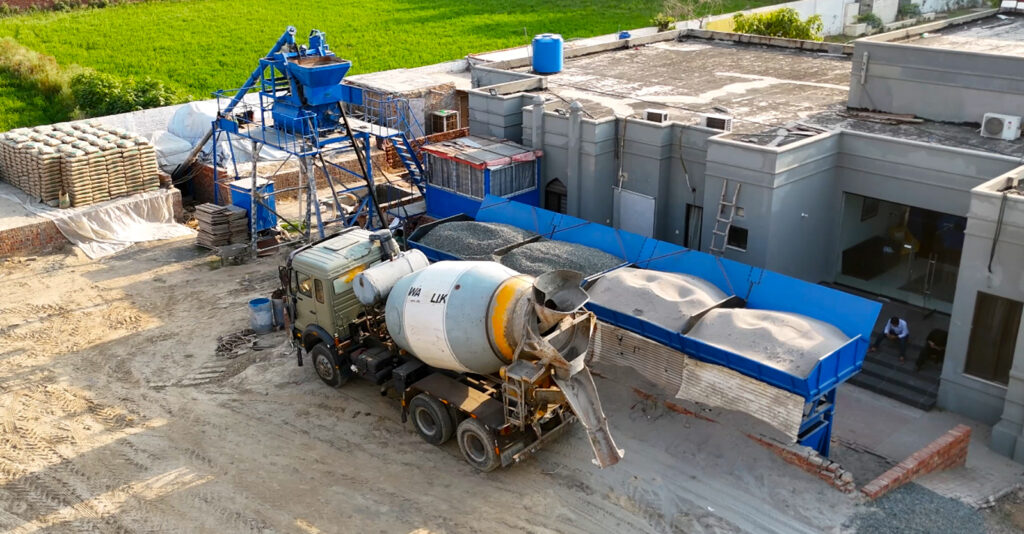

Batching Plant
March 2025
Excavation Work of 1st Part

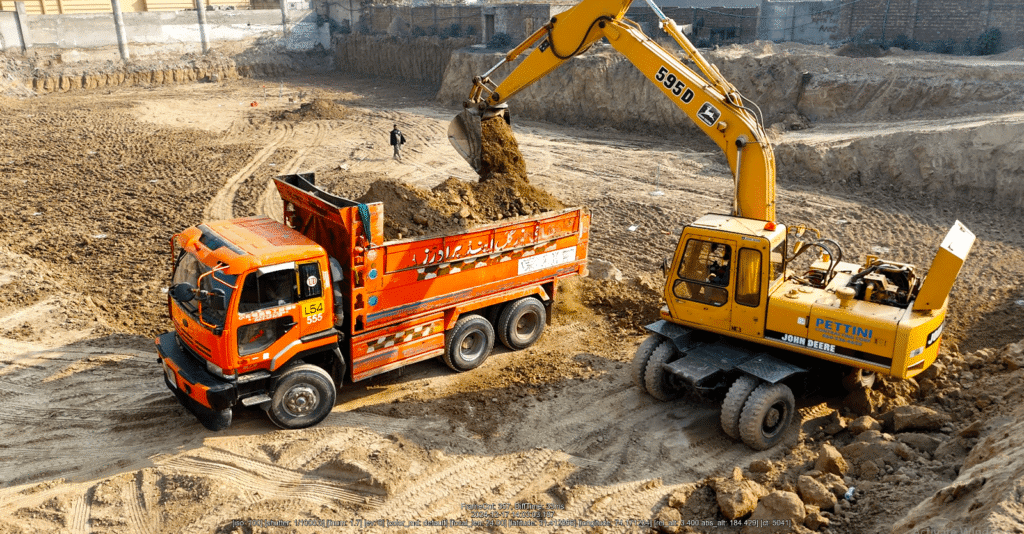

Excavation
April 2025
Plain Concerete Cementing of 1st Part and Excavation Work of 2nd Part

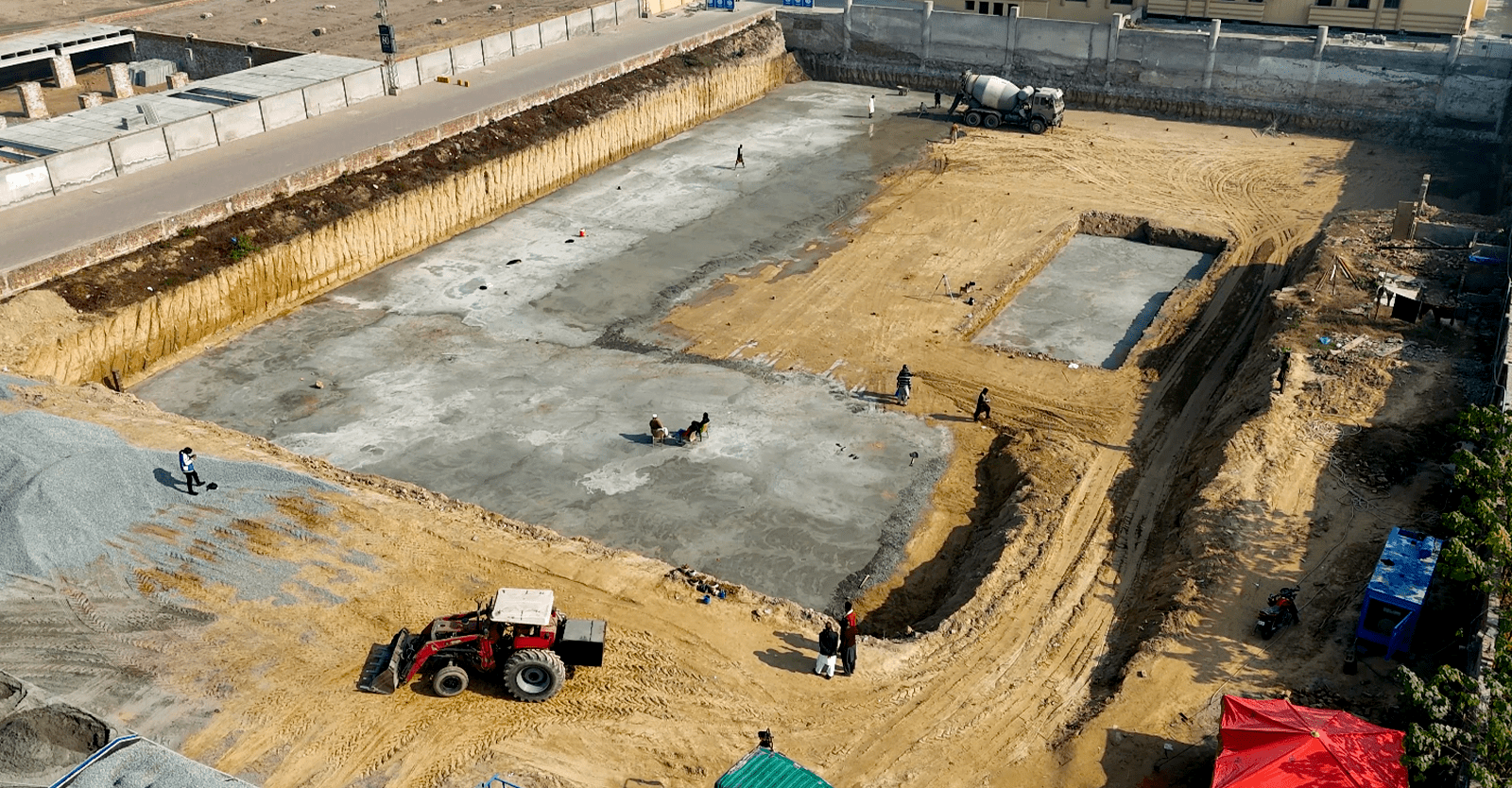

Half PCC
May 2025
Plain Concerete Cementing Work Part -2

Complete PCC
June 2025
Fixing and Placement of 60-Grade Steel Reinforcement for RCC Raft Foundation for stage one of basement, completed

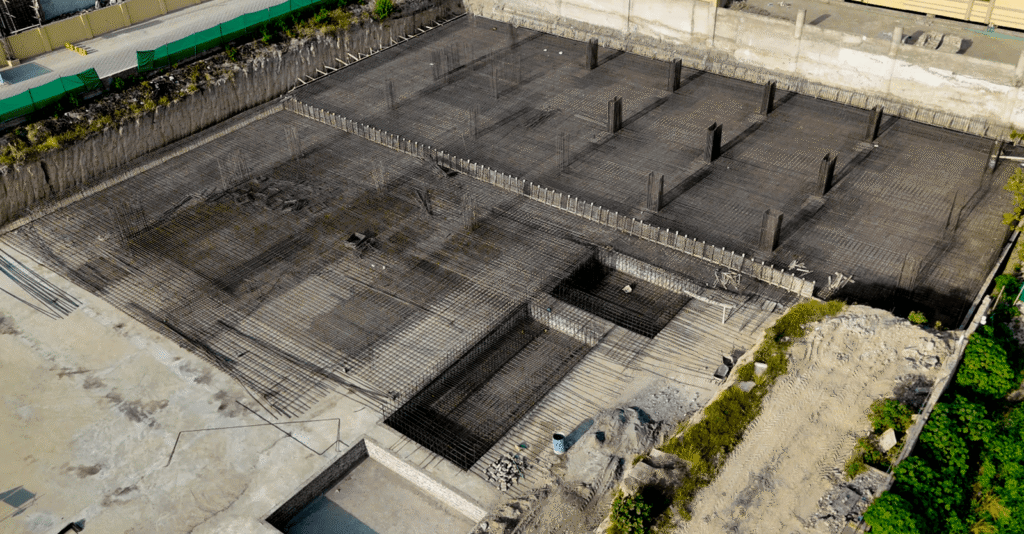

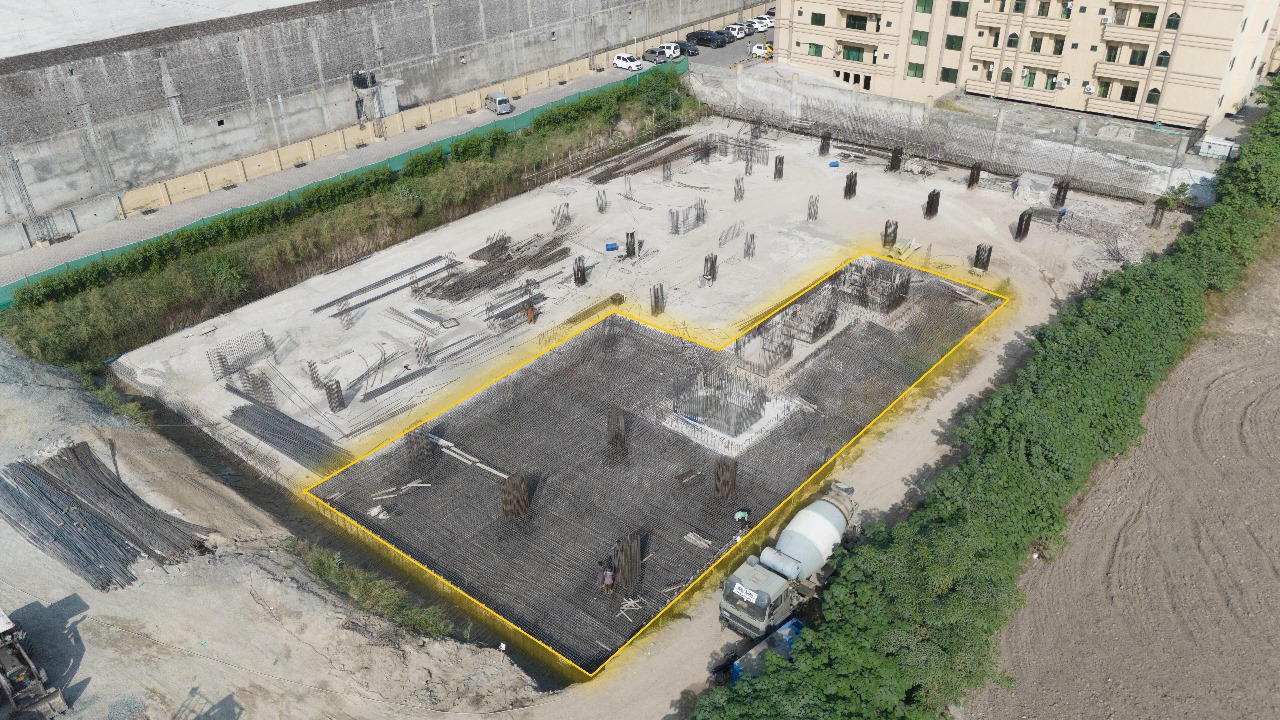

Raft Stage 1 steel
July 2025
On-site Batching and Pouring of Concrete for RCC Raft Foundation for stage one for basement, completed

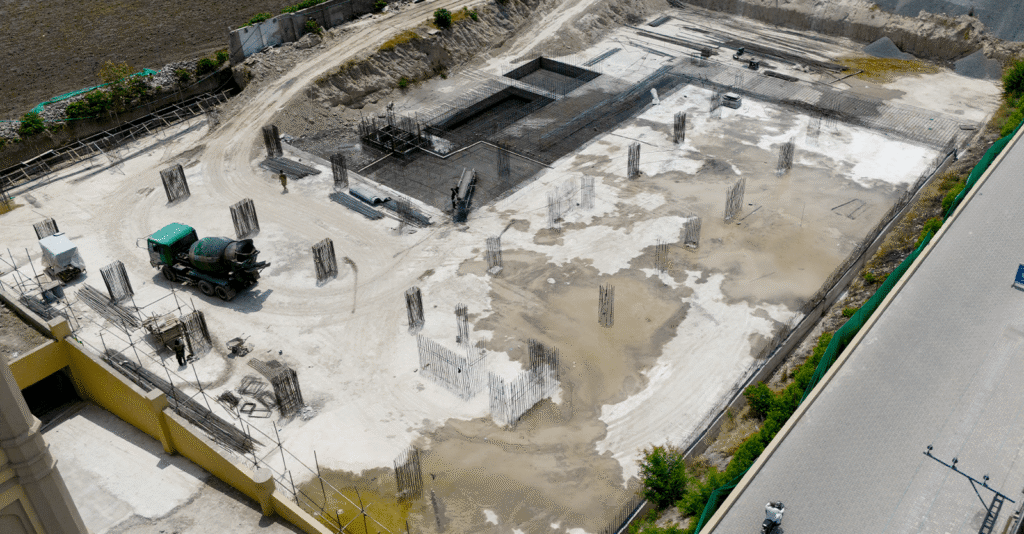

Raft stage1 Poured
August 2025
Fixing and Placement of 60-Grade Steel Reinforcement for RCC Raft Foundation for stage two of basement

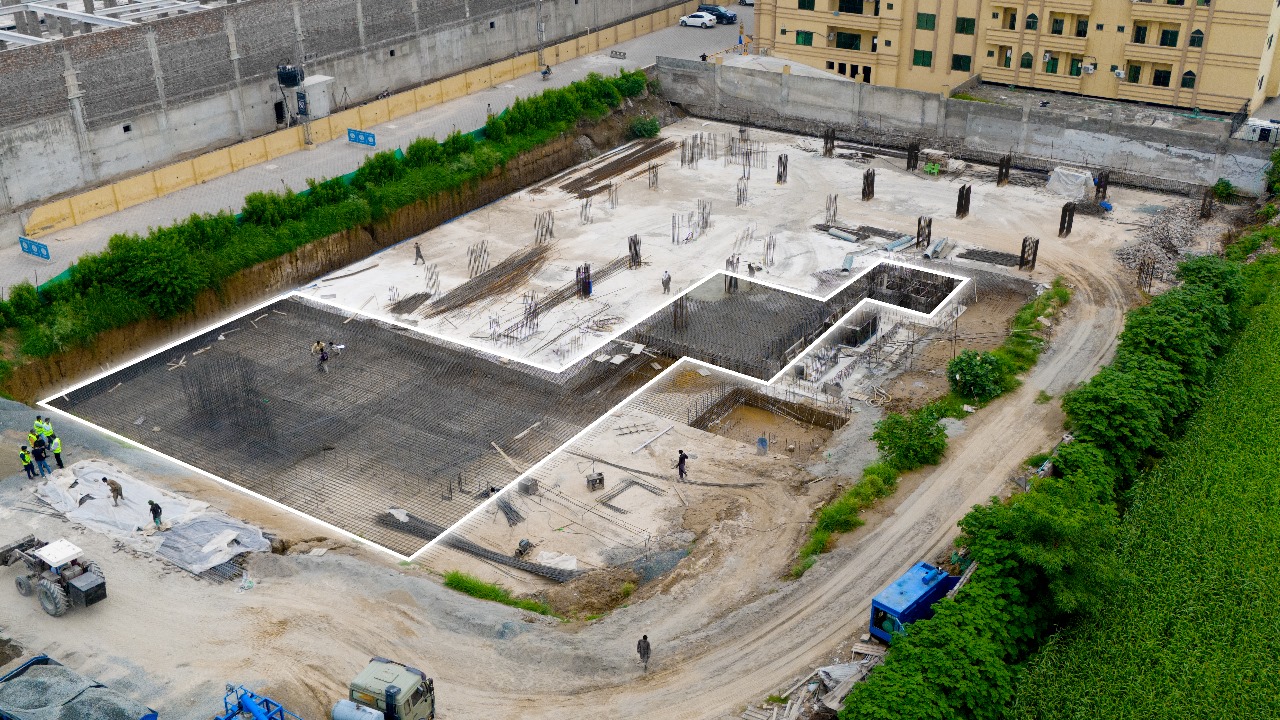

Fixing and Placement of 60-Grade Steel Reinforcement for RCC Raft Foundation for stage two of basement
September 2025
On-site Batching and Pouring of Concrete for RCC Raft Foundation for stage two for basement

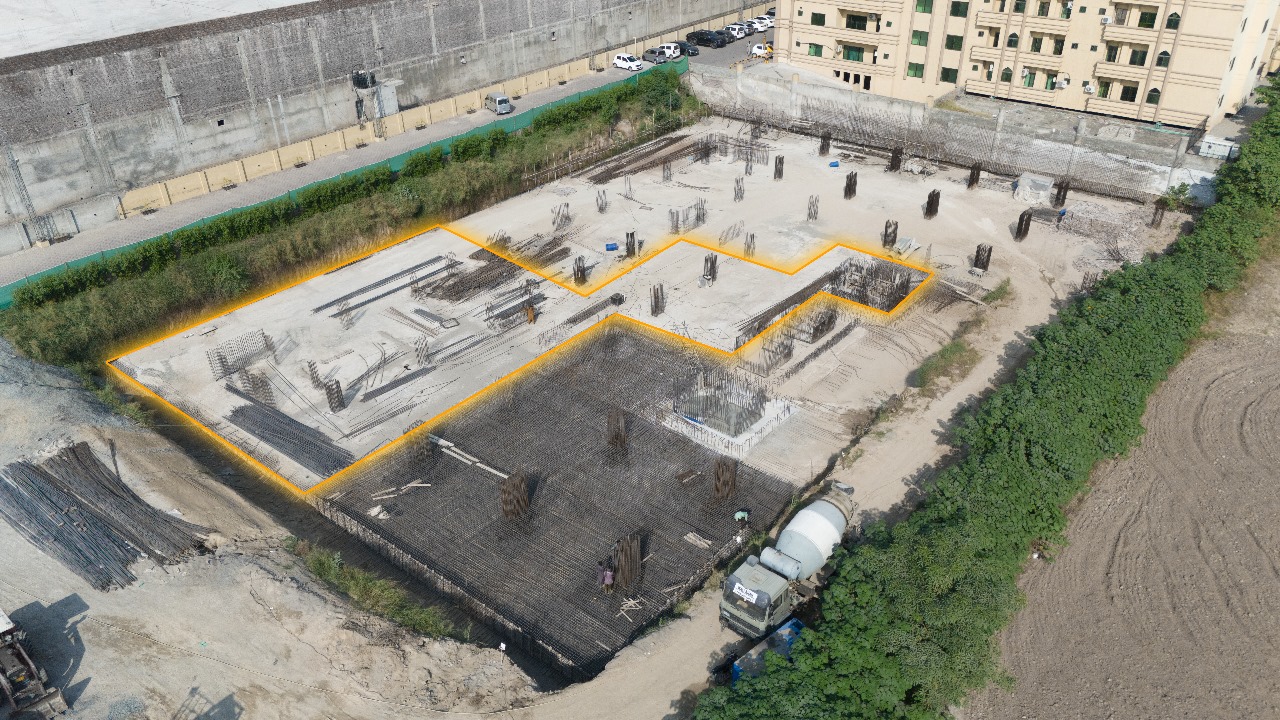

Mayfair Construction
October 2025
Fixing and Placement of 60-Grade Steel Reinforcement for RCC Raft Foundation for stage three of basement
November 2025
On-site Batching and Pouring of Concrete for RCC Raft Foundation for stage three for basement
December 2025
1st Part of the Basement Retaining Walls, Columns Beams and Slab
2026
January 2026
2nd Part of the Basement Retaining Walls, Columns Beams and Slab
February 2026
3rd Part of the Basement Retaining Walls, Columns Beams and Slab along with Execution of Ground Floor Structural Frame — First Phase Including RCC Columns, Beams, and Slab
March 2026
Execution of Ground Floor Structural Frame — Second Phase Including RCC Columns, Beams, and Slab
April 2026
Execution of Ground Floor Structural Frame — Third Phase Including RCC Columns, Beams, and Slab and Execution of 1st Floor Structural Frame — First Phase Including RCC Columns, Beams, and Slab
May 2026
Execution of 1st Floor Structural Frame — Second Phase Including RCC Columns, Beams, and Slab and Execution of 1st Floor Structural Frame
June 2026
Execution of 1st Floor Structural Frame — Third Phase Including RCC Columns, Beams, and Slab and Execution of 2nd Floor Structural Frame — First Phase Including RCC Columns, Beams, and Slab
July 2026
Execution of 2nd Floor Structural Frame — Second Phase Including RCC Columns, Beams, and Slab and Basement Brick Masonry Work & Allied MEP Works
August 2026
Execution of 3rd Floor Structural Frame — First Phase Including RCC Columns, Beams, and Slab and Ground Floor Brick Masonry Work & Allied MEP Works
September 2026
Execution of 3rd Floor Structural Frame — Second Phase Including RCC Columns, Beams, and Slab and First Floor Brick Masonry Work & Allied MEP Works
October 2026
Execution of 4th Floor Structural Frame — First Phase Including RCC Columns, Beams, and Slab and First Floor Brick Masonry Work & Allied MEP Works
November 2026
Execution of 4th Floor Structural Frame — Second Phase Including RCC Columns, Beams, and Slab and Second Floor Brick Masonry Work & Allied MEP Works
December 2026
Execution of 5th Floor Structural Frame — First Phase Including RCC Columns, Beams, and Slab and Second Floor Brick Masonry Work & Allied MEP Works
2027
January 2027
Execution of 5th Floor Structural Frame — Second Phase Including RCC Columns, Beams, and Slab and Second Floor Brick Masonry Work & Allied MEP Works
February 2027
Execution of 6th Floor Structural Frame — First Phase Including RCC Columns, Beams, and Slab and Second Floor Brick Masonry Work & Allied MEP Works
March 2027
Execution of 6th Floor Structural Frame — Second Phase Including RCC Columns, Beams, and Slab and Third Floor Brick Masonry Work & Allied MEP Works
April 2027
Execution of 7th Floor Structural Frame — First Phase Including RCC Columns, Beams, and Slab and Third Floor Brick Masonry Work & Allied MEP Works
May 2027
Execution of 7th Floor Structural Frame — Second Phase Including RCC Columns, Beams, and Slab and Third Floor Brick Masonry Work & Allied MEP Works
June 2027
Execution of 8th Floor Structural Frame — First Phase Including RCC Columns, Beams, and Slab and Third Floor Brick Masonry Work & Allied MEP Works
July 2027
Execution of 8th Floor Structural Frame — Second Phase Including RCC Columns, Beams, and Slab and 4th Floor Brick Masonry Work & Allied MEP Works
August 2027
Execution of 9th Floor Structural Frame — First Phase Including RCC Columns, Beams, and Slab and Fourth Floor Brick Masonry Work & Allied MEP Works
September 2027
Execution of 9th Floor Structural Frame — Second Phase Including RCC Columns, Beams, and Slab and 4th Floor Brick Masonry Work & Allied MEP Works
October 2027
Execution of 10th Floor Structural Frame — First Phase Including RCC Columns, Beams, and Slab and 5th Floor Brick Masonry Work & Allied MEP Works
November 2027
Execution of 10th Floor Structural Frame — Second Phase Including RCC Columns, Beams, and Slab and 5th Floor Brick Masonry Work & Allied MEP Works
December 2027
Execution of 11th Floor Structural Frame — First Phase Including RCC Columns, Beams, and Slab and 5th Floor Brick Masonry Work & Allied MEP Works
2028
January 2028
Execution of 11th Floor Structural Frame — Second Phase Including RCC Columns, Beams, and Slab and 6th Floor Brick Masonry Work & Allied MEP Works
February 2028
Brick Masonry Work of 7th, 8th Floors and MEP Works
March 2028
Brick Masonry Work of 9th , 10th and 11th Floors and MEP Works
April 2028
Internal Cement Plaster Work from Basement – 4th Floor
May 2028
Internal Cement Plaster Work from 4th – 11th Floor
June 2028
External June Cement Plaster Work External
July 2028
Plain Cement Concrete Sub-base
August 2028
Remaining Works
September 2028
Remaining Works
October 2028
Remaining Works
November 2028
Remaining Works
December 2028
Remaining Works
